With a floor plan of 146 m2, Trend G 146 combines functionality with high adaptability. It is one of those floor plan designs that can easily be adapted to the changing needs of family members over time and tailored to the needs of the customer.

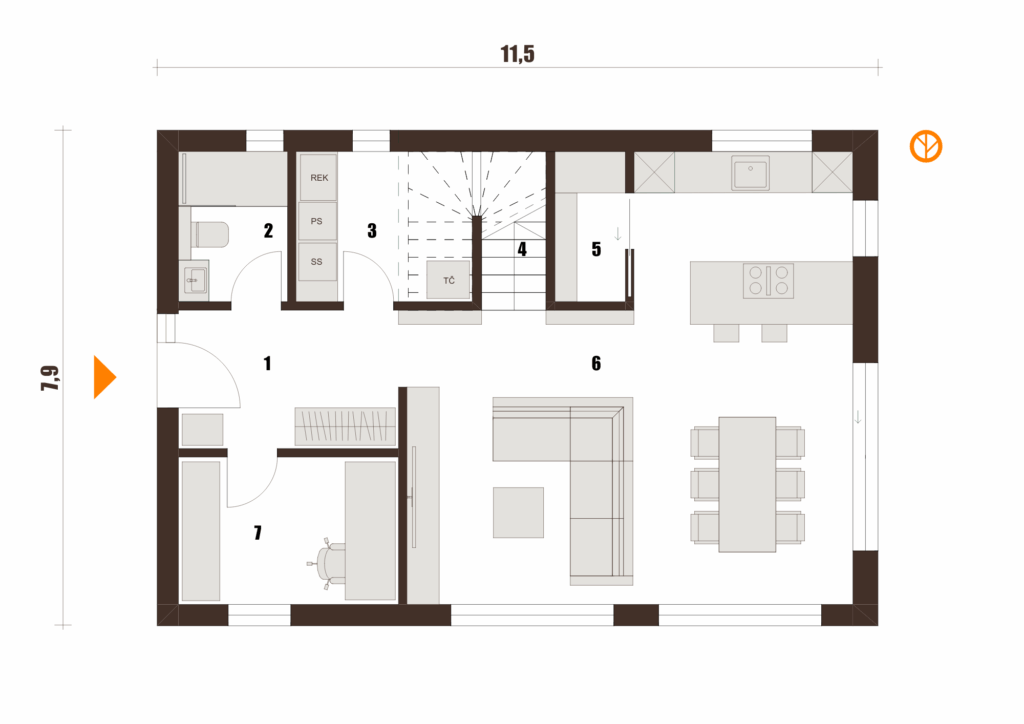

On the ground floor, a centrally designed entrance with an anteroom and wardrobe area leads into the living area, which is designed as a bright and open space. The living area is connected to the surrounding landscape by means of large glass surfaces, allowing for a visual expansion of the living area outward into the nature. A handy pantry ensures the maximum usability of the kitchen, while the climate comfort of the house is regulated from the utility, which also doubles as a laundry room. The comfort of the house is provided by an extra bathroom with a modern shower and an office that can be repurposed as a storage room.

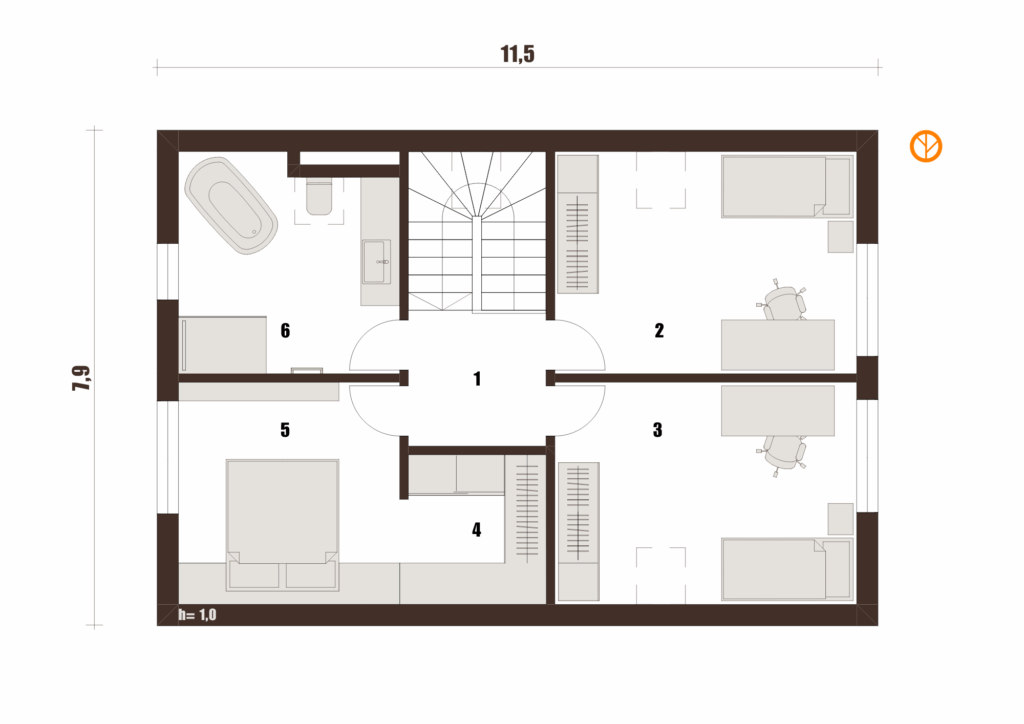

In the attic, two spacious and extremely bright children’s rooms can be found. They are illuminated through skylights, creating a bright and pleasant atmosphere that is perfect for playing or being creative. The master bedroom is equipped with a convenient walk-in closet, which provides even more practicality and comfort. There is also an impressive bathroom featuring a large shower with a contemporary design and enough space for installing a bathtub.



What are the benefits of a prefabricated home?
Get in touch for additional information
Customisation options
Construction stages
BASIC
3rd construction stage
Scope: Completed exterior structure
Duration: 90 days
- Construction site organization (construction sign, toilet, insurance during construction).
- Construction of a wooden house structure (external and internal walls, roof structure).
- Poduction and assembly of the wooden home.
- Installation of external joinery (windows, doors).
- Covering the house with roofing and sheet metal work.
- Insulation of the wall assembly with a decorative finishing layer.
MEDIUM
4th construction stage
Scope: Rough assembly work
Duration: 120 days
- All benefits of the Basic construction stage.
- Rough routing of electrical installations in walls.
- Rough routing of installations for heating and ventilation.
- Rough routing of plumbing installations.
- Closing of walls and ceilings.
- Execution of screed.
FINAL
5th construction stage
Scope: Turnkey home
Duration: 180 days
- All benefits of the Medium construction stage.
- Painting.
- Installation of fine electrical wiring (sockets, switches) and mechanical installations.
- Supply and commissioning of heating and ventilation equipment (e.g., heat pump).
- Ceramic works and floor coverings.
- Installation of sanitary equipment.
- Interior wooden stairs.
- Interior doors.
Advantages of our systems
Energy efficiency
Earthquake safety
four times lighter and more
adaptable than a brick one. It can withstand shocks up to
9th degree on the Richter scale.
